Mass calculator + sourcing guide

316 Stainless Steel Vacuum EOAT Manifold

Estimate 316 manifold mass, compare 6061, and prepare material, porting and QA requirements for your RFQ.

Request manifold DFM & quote

316 Manifold Mass & Payload Calculator

Edit all seven inputs to estimate mass and compare 6061. Robot dynamics remain unverified.

Jump to results ↓
Manifold mass screening inputs

1. Physical Dimensions & Cavity Parameters

Overall block length along main vacuum distribution gallery (30–600 mm).

Manifold block width across suction cup pick stations (30–500 mm).

Finished block height accommodating internal cross-drilled channels & thread engagement (15–150 mm).

Assumed removed volume (0–70%), not a validated machining or wall-strength limit. Use 0% if unknown.

2. Robot & Vacuum Tooling Payload

Enter a manufacturer-confirmed allowance for your robot configuration (0.5–150 kg). This tool does not determine it.

Include cups, fittings, valves, adapter, tool changer, fasteners and carried hoses; exclude this block and workpiece (0–50 kg).

Maximum production part mass gripped during high-acceleration cycle (0–50 kg).

Density basis: 316L = 8.00 g/cm³, 6061-T6 = 2.70 g/cm³.
Conceptual vacuum manifold: supply gallery and three cup outletsSupply inlet (example)Three example cup outlets
Concept only; not to scale. Gallery intersections and access plugs require deburring, sealing and cleaning access review.

Mass Screening Results

Review load data
Above 80% of entered mass allowance

Estimated carried mass uses 90.7% of the entered allowance. The 80% marker is an editorial review cue, not a robot safety limit. Verify center of gravity, inertia and motion with the robot manufacturer.

This is a mass estimate only. It does not verify robot dynamics, suction holding force, evacuation time, wall strength or sanitation. Removed volume is an assumption; confirm it from CAD. Method and limits.

Machined 316 Manifold
5.069 kg
(Solid: 6.758 kg)
6061 Same-volume Estimate
1.711 kg
Saving: 3.358 kg lighter
Total Carried Mass
9.069 kg
Block + other tooling + part
Arithmetic Mass Reserve
+0.931 kg
Entered allowance: 10 kg
Payload Capacity Utilization90.7%
0%80% review cue100%

* Screening estimate accounts for bounding box minus estimated channel volume. Actual mass will be confirmed against your exact CAD STEP model before CNC setup.

Four decisions before releasing a 316 manifold drawing

  1. Decide whether welding favors 316L. Its lower carbon reduces weld-related sensitization risk. Confirm the exact grade on the material certificate. Outokumpu, pp. 1–2.
  2. Quantify the mass penalty. This model uses nominal densities of 8.00 and 2.70 g/cm³: the same retained volume is about 2.96× heavier in stainless. This comparison does not prove interchangeable geometry. Stainless density, p. 8; Hydro alloy reference, p. 2.
  3. Keep robot approval separate. Combined tool and part mass, center of gravity and inertia affect the robot load review. A positive difference in kilograms is insufficient. Manufacturer load guidance.
  4. Define how to verify the part. A leak method, finish target or material name alone cannot demonstrate cleanability. Agree drawing zones, inspection access and acceptance criteria before ordering. EHEDG design principles; ISO tracer-gas method scope.
Estimate mass → Review application → Agree acceptanceEstimate massReview applicationAgree acceptance
Use the calculator to expose a mass issue early; release the design only after application and acceptance review.

Method, defaults and known limits

Inputs update the result immediately in your browser. There is no server calculation or waiting state. All fields are required. Empty or out-of-range values clear the calculated outputs and retain a manual RFQ path.

1. Retained volume

V = L × W × T × (1 − R/100)

L, W, T in mm; R is an assumed removed-volume percentage. V is in mm³.

2. Estimated block mass

m = V × density × 10⁻⁶

Density in g/cm³, m in kg. Nominal density is 8.00 for 316/316L and 2.70 for 6061.

3. Arithmetic reserve

reserve = allowance − (m + tooling + part)

Utilization = total / allowance. At or above 100%, no positive reserve remains. The 80% review cue is editorial.

Table 1: What is calculated, assumed or still unknown · Scroll horizontally on narrow mobile screens.
ItemBasisDecision limit
Default geometry220 × 120 × 32 mm; 25% removed volumeIllustrative baseline, not a validated production design. Use 0% removed volume if unknown.
Default carried load1.5 kg other tooling + 2.5 kg part; 10 kg entered allowanceInclude every carried component. The tool cannot establish the robot allowance.
Nominal densityOutokumpu: 8.0 kg/dm³; Hydro: 0.098 lb/in³ (rounded nominal model: 2.70 g/cm³)Near-room-temperature screening; confirm CAD material and supplied alloy.
Calculated outputsVolume-based block mass, total carried mass, arithmetic reserveDisplayed to 0.001 kg for reproducibility, not measurement accuracy.
Unknown geometryActual galleries, plugs, pockets and fastenersCAD-derived volume and a weighed assembly supersede this estimate.
Unassessed performanceRobot dynamics, wall strength, holding force, evacuation and cleaningRequires separate application review and testing. No safety factor is derived.

Reduction includes both air passages and external pockets; the calculator cannot tell them apart. A larger reduction does not by itself justify thinner walls, additional cavities or a faster vacuum response.

Material alternatives and the reason to specify each

Table 2: Material decision matrix; performance remains application-specific · Scroll horizontally on narrow mobile screens.
OptionReason to review itEvidence still needed
316Molybdenum-bearing stainless option for a corrosion-driven review.Exact grade, product form, chemistry and material traceability.
316LLow-carbon alternative when welded plugs or welded interfaces are proposed.Weld process, final condition and inspection requirements.
304Alternative to assess when the environment does not justify the 316 specification.Application-specific corrosion comparison; do not substitute from price alone.
6061-T6Lower same-volume mass; use the comparison as a redesign starting point.Strength, sealing, coating and cleaning compatibility of the actual design.

Alloy descriptions: Outokumpu Supra datasheet. Aluminum properties and finishing context: Hydro 6061 datasheet. The model does not assign material prices, corrosion lifetimes or a certification status.

Compare the 304 manifold guide or review the material options.

Washdown chemistry: information needed before selection

The alloy datasheet treats corrosion resistance as dependent on the medium and service conditions. It does not establish a universal sanitizer approval. Corrosion discussion, pp. 3–4.

Table 3: Buyer inputs for a chemistry review, not compatibility approvals · Scroll horizontally on narrow mobile screens.
ExposureRecord these conditionsMinimum next step
Chloride-bearing solution or brineChemical identity, chloride level, temperature, dwell and crevicesAsk the material specialist to assess the full exposure and propose testing if evidence is insufficient.
Caustic, acidic or oxidizing cleanerActual product, working concentration, mixing sequence, temperature and rinsingReview the block, closure, seals and fittings together using supplier compatibility data.
Steam or thermal cyclingTemperature, pressure, cycle duration and seal specificationAgree thermal and sealing validation for the assembled manifold.
Unspecified plant cleanerUnknown: current cleaning procedure and product dataObtain the procedure before approving material or finish.

These are review questions rather than claimed chemical limits. If the exposure is unresolved, keep material suitability open in the RFQ instead of assuming that 316 is immune.

Cleanability starts with access and a defined contact zone

Separate the external washdown surface from any passage that can receive product, condensate or cleaning fluid. For each zone, document how it can be reached, cleaned, drained and inspected. Follow the applicable equipment guidance and validate the cleaning process. EHEDG Document 8 catalogue.

Drawing requirements to agree

Identify contact zones, closure interfaces, finish measurement locations and any internal access restrictions. A requested Ra value needs an agreed achievable finish and inspection method for that particular surface.

Evidence before a hygiene claim

Ask for the applicable certificate scope and cleaning validation evidence. An alloy, smooth bore, welded plug or a stated dead-leg ratio alone does not establish EHEDG or 3-A certification.

Map contact zones → Provide access → Validate cleaningMap contact zonesProvide accessValidate cleaning
A cross-drilled blind extension remains a design-review item even when the exterior can be washed down.

Machining, tolerances and port sealing

Route the vacuum gallery from the inlet to each cup, then identify every drilling intersection, closure and potential chip trap. Process capability and inspection access must be confirmed against the actual CAD file; this guide does not promise a universal deep-hole ratio, roughness or minimum web thickness.

Table 4: Drawing-to-inspection handoff · Scroll horizontally on narrow mobile screens.
FeatureSpecify on the drawingEvidence to request
Robot mounting interfaceDatum scheme, bolt pattern, dowels and mating interfaceDimensional report against the controlled drawing revision.
Cup mounting and seal facesFunctional flatness/position limits and finish zonesInspection method tied to sealing function and accessible surfaces.
Internal gallery intersectionsBore routing, permitted breakout and cleaning accessDeburring/cleaning plan and agreed inspection coverage.
Pockets and channel wallsRemaining ligament, span and load conditionsStructural/deflection review before accepting weight removal.
Ports and closuresThread designation, seal geometry, mating fitting, torque and closure processSupplier seal requirements and assembled leak test.

Choose a complete sealing interface

A parallel thread needs its specified sealing feature; thread designation alone is incomplete. Compare removable plugs with permanent closures for cleaning access, service and weld effects. Control sealant and particle requirements explicitly. No blanket prohibition on a thread family or unsupported “zero leakage” guarantee is implied.

Route channels → Plan closures → Inspect assemblyRoute channelsPlan closuresInspect assembly
Resolve manufacturing access and inspection coverage before finalizing gallery locations.

Robot load review: what a kilogram reserve leaves unknown

Use the documentation for the exact robot version. Universal Robots identifies payload mass, center of gravity and inertia as load parameters; motion capability can change with the configuration. Maximum payload guidance. This page deliberately does not interpolate a generic derating curve.

  • Calculate combined CoG and inertia for the block, all other tooling and each carried part condition.
  • Include adapters, valves, fittings and carried cable/hose masses in the estimate; confirm externally applied hose forces separately.
  • Check intended orientations, acceleration, emergency stopping and the programmed load states through the manufacturer process.
  • For vacuum selection, assess cup geometry, part leakage, total evacuated volume, supply characteristics and required timing. Schmalz system design workflow.
Mass + CoG + inertia → Manufacturer review → Commission motionMass + CoG + inertiaManufacturer reviewCommission motion
A green mass card only describes arithmetic reserve. It does not validate grip, robot motion or a safety function.

Three reproducible screening examples

These are hypothetical calculations, not customer case studies or field results. They use the same mass formula as the tool; every robot and vacuum conclusion remains open. All dimensions are in mm and masses in kg.

Table 5: Example inputs → calculation → next decision · Scroll horizontally on narrow mobile screens.
Example and inputsCalculated outputInterpretation and next step
A — Baseline: 220 × 120 × 32; R=25%; other tooling=1.5; part=2.5; allowance=10316 block 5.069; 6061 comparison 1.711; carried mass 9.069; reserve +0.931; use 90.7%Above the editorial 80% cue. Confirm actual removed volume and obtain robot load review.
B — Same block and masses as A; allowance reduced to 8316 block 5.069; carried mass 9.069; reserve −1.069; use 113.4%Entered mass allowance exceeded. Reassess geometry, material and robot selection; do not infer that deeper pocketing is feasible.
C — Compact block: 180 × 100 × 25; R=20%; other tooling=1; part=1; allowance=8316 block 2.880; 6061 comparison 0.972; carried mass 4.880; reserve +3.120; use 61.0%Below the entered allowance. CoG, inertia, wall strength and vacuum performance remain unverified.

Reproduce an example in the calculator ↑

Baseline calculator execution

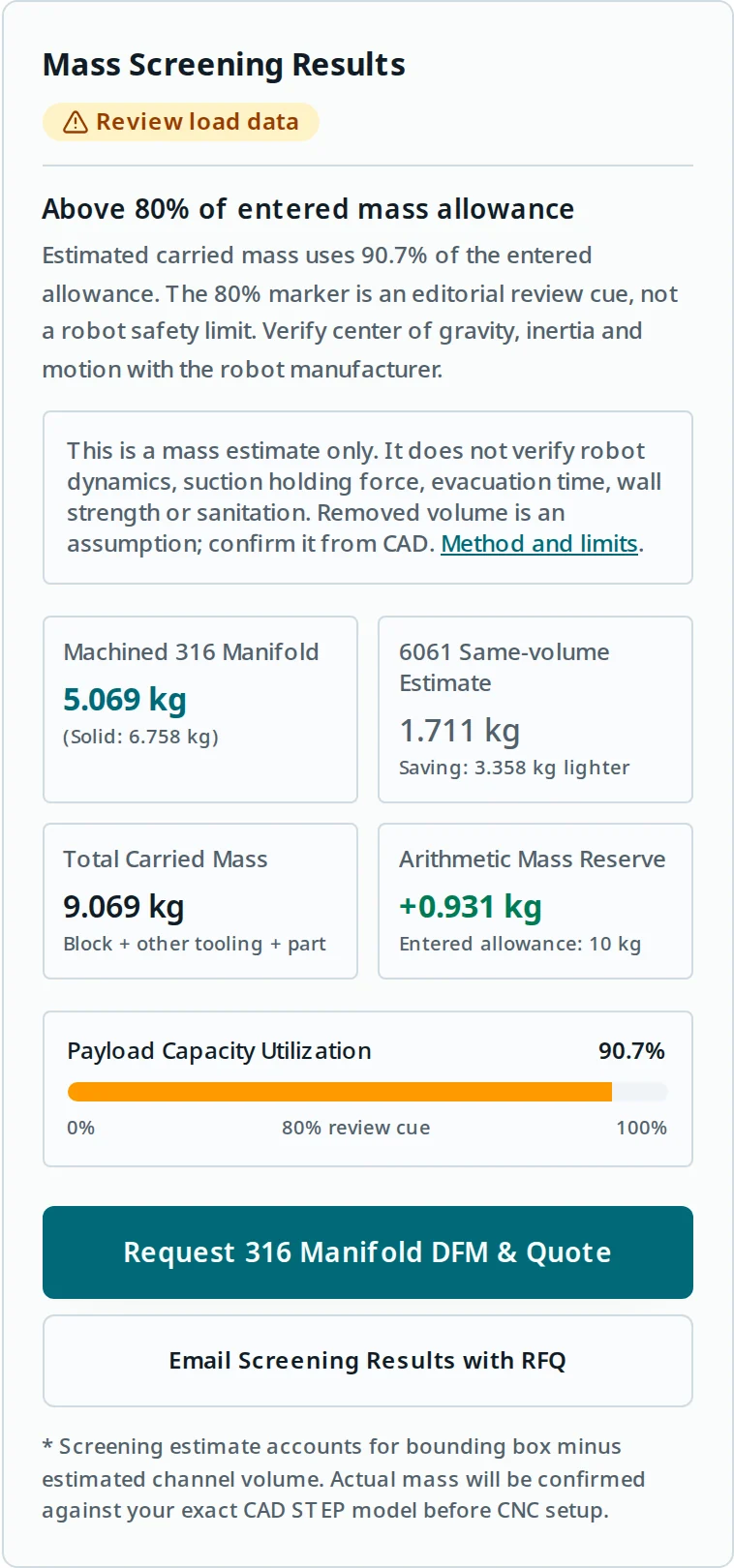

316 vacuum manifold calculator baseline: 5.069 kg block, 9.069 kg carried mass and +0.931 kg arithmetic reserve
Actual software execution captured October 23, 2026. Inputs: 220 × 120 × 32 mm, 25% removed volume, 1.5 kg other tooling, 2.5 kg workpiece and 10 kg entered allowance. Only the result card is captured; site navigation and floating controls are outside the frame. This demonstrates reproducible arithmetic, not a physical manifold test, customer result or robot approval.

QA evidence: agree the test before accepting a result

ISO 20485:2017 covers tracer-gas leak detection techniques; the public scope does not set a universal leak limit for an EOAT manifold. Official ISO record. Put the agreed limit and test conditions in the purchase specification.

Table 6: Acceptance plan to include in the RFQ · Scroll horizontally on narrow mobile screens.
EvidenceDefine before orderingWhat it does not prove
Material traceabilityExact grade/product specification, heat identification and required certificateCompatibility with an unspecified cleaner.
Dimensional reportCritical datums, features, tolerances, method and samplingVacuum holding force or cleaning performance.
Chemical passivationApplicable ASTM A967/A967M revision, selected treatment and verification methodAn achieved internal roughness or application-specific corrosion life.
Manifold leak testTest gas, differential pressure, temperature, connections capped, calibration, units and limitCup leakage against the production workpiece or complete system evacuation time.
Functional vacuum trialActual workpiece, cup condition, supply, target pressure, timing and fault responseRobot load approval or sanitary certification.
Cleaning and packagingResidue criteria, accessible inspection zones, drying and packagingValidated sterile operation without the required process evidence.

ASTM A967/A967M-25 defines passivation treatments and verification scope. A finish target, test capability or certificate is a quotation requirement to confirm, not an automatic service guarantee. See our quality process.

Risk, cost and scenario mismatch

Table 7: Decision risks and minimum mitigation · Scroll horizontally on narrow mobile screens.
RiskPractical consequenceMitigation or alternative
Treating reserve as robot approvalUnverified motion or stopping behavior despite a positive kg balance.Complete manufacturer load review and commissioning for the actual assembly.
Increasing volume reduction to pass the toolPossible weak webs, interrupted sealing faces or inaccessible cavities.Compare CAD mass and structural deflection; consider a different envelope or material.
Specifying every surface as highly polishedAdditional processing, difficult internal inspection and avoidable quotation cost.Zone surfaces by function; request a quoted finishing and inspection plan.
Choosing 316 for a dry, mass-limited applicationA mass penalty without an established corrosion requirement.Review an aluminum design and verify its environment and coating separately.
Assuming washed exterior means clean internalsUnverified residue removal in galleries and closures.Map contamination routes and agree access, drainability and cleaning validation.
Unqualified leak limit or delivery promiseIncomparable quotations and disagreement at acceptance.Specify test conditions and quantity; request capability, cost and delivery confirmation.

No current price or lead-time estimate is claimed. Alloy availability, batch size, access drilling, finishing, closure work and test documentation must be priced against the controlled design.

Sources, dates and evidence boundaries

Published by EOAT Machining on . Reviewed and primary source links checked . Numerical examples are derived calculations; purchasing and validation checklists are application review guidance.

  • Outokumpu Supra datasheet — alloy context, low-carbon welding rationale, corrosion caveats and physical properties (pp. 1–4, 8). Material data does not certify this manifold.
  • Hydro 6061 datasheet — reference density of 0.098 lb/in³ (p. 2), plus alloy/temper context. The calculator uses rounded nominal 2.70 g/cm³, not a measured batch density.
  • Universal Robots maximum payload manual — model/version-specific load review. No universal CoG thresholds or derived kg-versus-offset curve are claimed.
  • EHEDG hygienic design principles, GL 8 (fourth edition, December 2025) — official catalogue and scope. Detailed requirements need the applicable document and application review; no certification is asserted.
  • ASTM A967/A967M-25 — public treatment and verification scope. The selected treatment must be agreed for the part.
  • ISO 20485:2017 — official tracer-gas method scope. Numerical acceptance limits are buyer/supplier decisions, not values inferred from the title.
  • Schmalz system design workflow — complete system selection and trials with original parts. It does not validate this block or establish a universal gallery diameter.

Still unknown without your application: exact CAD mass, feasible pocket volume, allowable robot load, chemical compatibility, internal cleanability, leakage limit and cycle time. Public evidence on this page cannot resolve those variables.

Turn the screening into a reviewable RFQ

  • Revision-controlled STEP file and 2D drawing with material, datums, critical tolerances and finish zones.
  • Port schedule, mating fittings, access closures, intended vacuum and any positive-pressure blow-off or test conditions.
  • Robot version, all carried masses, combined CoG/inertia, operating orientations and cycle requirements.
  • Cleaning products and conditions, contact zones, cleaning access and required evidence.
  • Prototype/production quantities, destination, requested delivery and agreed QA/test requirements.

For confidential designs, request NDA terms and confirm the approved file-transfer route before sending restricted CAD. Email summaries do not attach files automatically; attach approved files yourself.

Request manifold DFM & quotation

Inquiry Email

[email protected]

Attach your CAD files (STEP, IGES) and tolerances for quick quoting.

Instant Chat

+8618857971991

Direct response from our engineering team.

Related interfaces: 316 EOAT brackets · 316 mounting plates.

Frequently asked engineering and sourcing questions

Material and hygiene decisions

When should I choose 316L rather than 316?

Consider 316L for welded construction because lower carbon reduces susceptibility to weld-related intergranular corrosion. Specify the exact alloy and product standard on the drawing; confirm the supplied heat certificate. See the Outokumpu source below.

Is a 316 manifold compatible with every washdown chemical?

Compatibility remains application-specific. Give the reviewer the chemical identity, concentration, temperature, exposure time and rinse sequence. Include seals and fittings in that review; a stainless block alone does not establish system compatibility.

Does an electropolished finish prove sanitary certification?

A finish specification describes one surface characteristic. Certification, cleaning validation, seal design and access to every contaminated surface require separate evidence. Do not infer EHEDG or 3-A certification from the alloy or an Ra value.

Can aluminum be substituted to reduce mass?

Use the same-volume estimate to quantify the mass tradeoff, then review the proposed alloy, coating, chemistry, strength and sealing geometry. A lighter estimate is not approval for the same drawing or cleaning process.

Calculator and robot selection

What does the mass calculator actually calculate?

It multiplies the block bounding volume by a user-entered retained-volume fraction and nominal density, then adds all other carried tooling and the part. Arithmetic reserve is the entered allowance minus that total. It does not calculate vacuum performance or robot dynamics.

What if I do not know the removed-volume percentage?

Use 0% as a conservative solid-block starting point for this geometry. Replace it with a CAD-derived fraction when available. The example starts at an assumed 25%; the tool cannot check whether those pockets or galleries are feasible.

Does a positive reserve mean the robot can run the design?

Robot acceptance is still unverified. Check the exact robot configuration, combined tool and part center of gravity, inertia, orientation, acceleration and motion program using the manufacturer documentation and commissioning process.

Is the 80% marker a safety factor?

It is only an editorial cue to review load data more closely. It is not a manufacturer limit or a validated safety factor. An estimate below 80% still needs the same robot and vacuum verification.

Manufacturing and procurement

What channel diameter and minimum wall should I specify?

Determine them from the complete vacuum network, access drilling, pressure differential, mounting loads, span and deflection budget. There is no universal bore or web thickness established by this page. Submit CAD and operating conditions for review.

How should cross-drilled access holes be sealed?

Compare serviceable plugs and permanent closures against leak limits, maintenance access, cleaning and thermal effects. Specify the mating seal interface, closure process and inspection method. Confirm the fitting manufacturer requirements instead of assuming thread form alone seals the joint.

Does ISO 20485 prescribe a universal manifold leak limit?

The public ISO 20485:2017 scope describes tracer-gas leak detection techniques. The buyer and supplier must agree the applicable test arrangement, conditions, units, sensitivity and acceptance limit for this manifold. No leak-rate guarantee is made here.

What should accompany an RFQ or confidential CAD file?

Include a revision-controlled STEP file and drawing, port schedule, exact material, finish zones, tolerances, quantity, robot loads, cleaning conditions and test acceptance criteria. Request NDA terms and confirm the approved transfer channel before sending restricted design files.
